Traffic Management Enhancement Project Phase 4 - Goodfellow Boulevard

Traffic Management Enhancement Project Phase 4 - Goodfellow Boulevard is a federally supported transportation improvement project in Saint Louis, Missouri.

Project Overview

Goodfellow Boulevard is a key transportation corridor in northern Saint Louis, Missouri. As a minor arterial road, it connects two wards and seven neighborhoods to essential goods, services, and destinations, including the U.S. Army Reserve Center, Barrett Brothers Park, Pierre Laclede Junior Career Academy, major industrial areas, and Interstate 70. Upgrading this vital multimodal route will reduce vehicle emissions, and enhance mobility, safety, and accessibility for pedestrians, cyclists, motorists, and transit users.

Project Location / Description

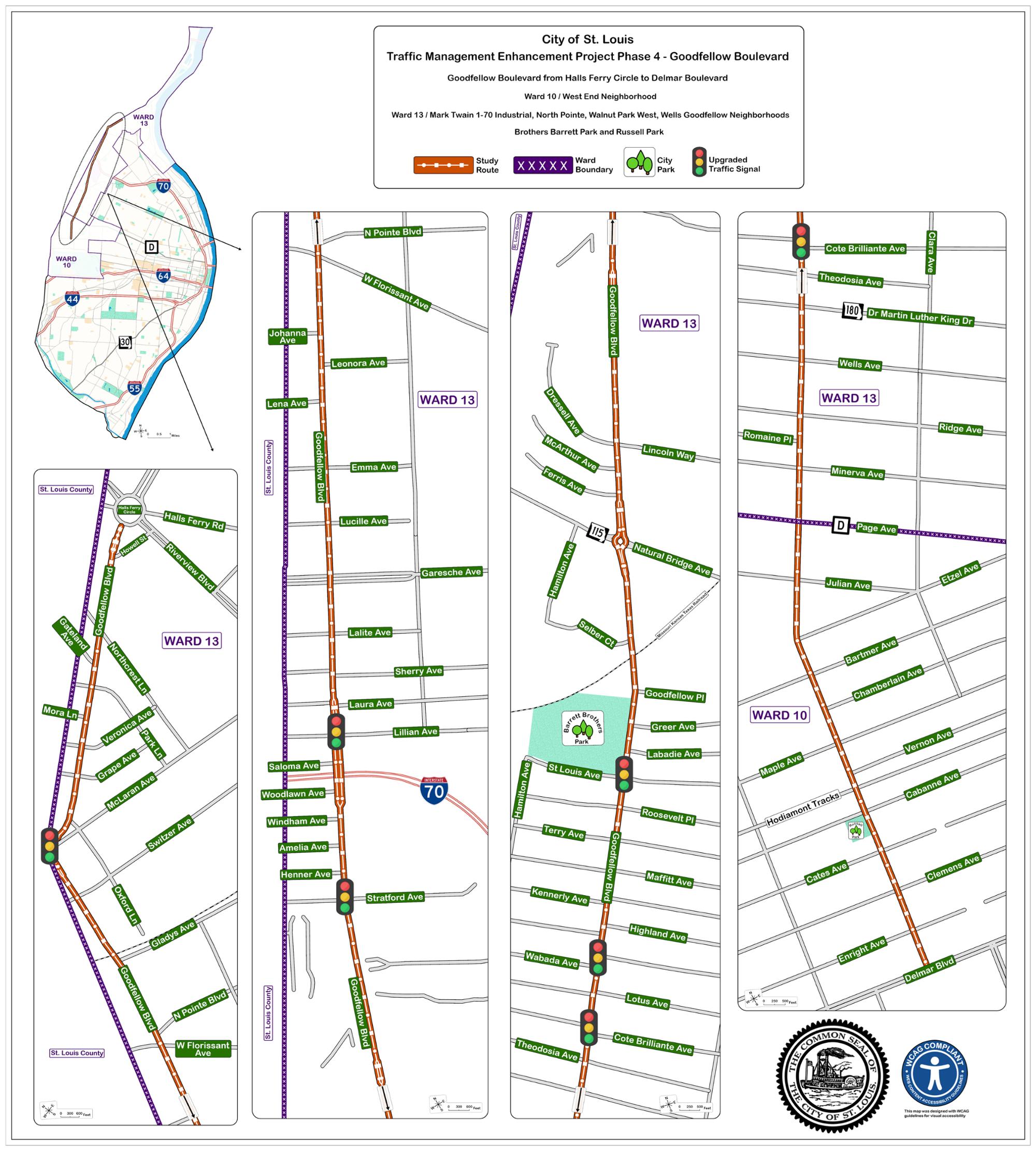

The 3.75-mile project corridor runs along Goodfellow Boulevard from Halls Ferry Circle in the north to Delmar Boulevard to the south. There is a significant need to maintain and improve traffic management and safety within the City’s complex transportation network, including the reduction of motorists travel times and vehicle emissions. This project enhances the Intelligent Transportation System (ITS) infrastructure, enabling the Real-Time Transportation Intelligence Center (TIC) to better manage traffic incidents and congestion.

Project Objectives

Traffic Flow Improvements:
•    Upgraded traffic signal controllers and equipment at eight locations along project corridor
•    ADA compliant traffic signals
•    Traffic signal replacement, timing, and interconnection
•    Fiber optic communications
•    Traffic monitoring Pan-Tilt-Zoom (PTZ) cameras linked to TIC
•    Installation of fiber optic communications along missing gaps along project route
•    System integration for traffic signal support
•    TIC operations staffing
•    Minor fiber optic connections along Halls Ferry Road and Dr. Martin Luther King Drive

Project Budget

•    Preliminary Engineering/Planning/Environmental Studies:
      Total Cost: $775,000
      Federal Funds: $620,000
      Local Funds: $155,000

•    Right of Way (ROW)
      Total Cost: $0
      Federal Funds: $0
      Local Funds: $0

•    Construction/ Engineering
      Total Cost: $144,000
      Federal Funds: $115,200
      Local Funds: $28,800

•    Construction/Implementation
      Total Cost: $3,081,000
      Federal Funds: $2,464,000
      Local Funds: $616,200

•    Total Cost: $4,000,000
      Federal Funds: $3,200,000
      Local Funds: $800,000

Project Schedule

•    Engineering Services Contract Submitted and Approved: February 2020 - April 2020
•    Public Meeting/Hearing: N/A
•    Submit and Receive Approval for Proceed for Right of Way Acquisition (A-Date): N/A
•    District Approval of Plans, Specifications, and Estimates (PS&E) advertise for bids: October 2021 - December 2021
•    Project Implementation/Construction: April 2022 - December 2022

Location Info

Northwest Saint Louis, Missouri

Documents

None at this time
